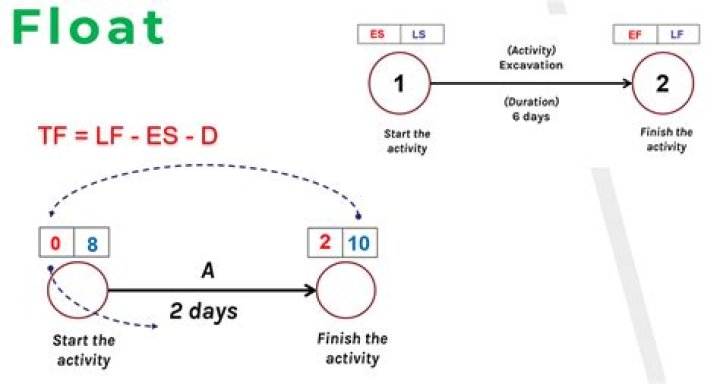

How do you calculate float?

Free float is how long an activity can be delayed without delaying the Early Start of its successor. You can calculate the free float by subtracting the Early Finish Date of the activity from the Early Start Date of the next activity.

What is float in network diagram?

Float, sometimes called Slack (float) , is the amount of time an activity, network path, or project can be delayed from the early start without changing the completion date of the project. Total float is the difference between the finish date of the last activity on the critical path and the project completion date.

How do you calculate float in CPM?

Formulas for calculating Total Float and Free Float are as follows:

  1. Total Float = LS – ES (it is also calculated by LF – EF)Free Float = Lowest ES of successors – EF.
  2. Free Float = Lowest ES of successors – EF.

How do you calculate network diagram?

  1. First approach – You calculate the network diagram starting on day 0.
  2. Second approach – You calculate the network diagram starting on day 1.
  3. Early Start = EF of predecessor activity + 1.
  4. Early Finish = ES + activity duration – 1.
  5. Late Finish = LS of successor activity – 1.
  6. Late Start = LF – activity duration + 1.

What is float in network analysis?

In project management, float or slack is the amount of time that a task in a project network can be delayed without causing a delay to: subsequent tasks (“free float”) project completion date (“total float”).

What is float time networking?

Float, sometimes called slack, is the amount of time an activity, network path, or project can be delayed from the early start without changing the completion date of the project.

How do you calculate total float float and free float?

Free float is measured by subtracting the early finish (EF) of the activity from the early start (ES) of the successor activity. Free float represents the amount of time that a schedule activity can be delayed without delaying the early start date of any immediate successor activity within the network path.

How do you calculate float time in critical path analysis?

To determine float, follow this process:

  1. Find the second longest sequence of activities in the network diagram.
  2. Subtract its total duration from the duration of the critical path sequence.
  3. The difference between the two durations will give you the float for each activity in the second sequence.

How do you calculate independent float?

Independent float is that portion of the total float within which an activity can be delayed for start without affecting the float of the preceding activities. It is computed for an activity by subtracting the tail event slack from its total float.

How do you calculate ES LS EF LF?

Formulas for calculating Total Float and Free Float are as follows:

  1. Total Float = LS – ES (it is also calculated by LF – EF)
  2. Free Float = Lowest ES of successors – EF.

How do you calculate independent float on a network diagram?

What is total float in network analysis?

Total Float is the amount of time that an activity can be delayed from its early start date without delaying the project finish date. Free Float is the amount of time that an activity can be delayed without delaying the early start date of any successor activity.

How do you calculate float in project management?

How To Calculate Float In Project Management. Step 1 –Create the project schedule network diagram. Step 2 – Find out the critical path. Step 3 – Find the next longest path and find the float. Step 4 – Continue Step 2 until traversing through all the paths in the project. Conclusion.

What is the float of an activity in network diagram?

The float of an activity is the amount of time you can slip without delaying the overall project timelines or schedule. Fortunately calculating float for an activity in a network diagram is not so difficult.

How to calculate total float?

Simple formula to calculate total float is our usual formula i.e. LS (Late Start) – ES (Early Start) or LF (Late, Finish) – EF (Early Finish) Now comes the real challenge, Free Float is different to Total Float and yes, it’s not a small difference which can confuse one with another.

Which is the longest path through the network diagram?

Critical path is the LONGEST path out of all paths in the specific precedence network. You have it listed as shortest. Nick, the longest path through network diagram is the critical path – which is the shortest path for the completion of the project. Is the calculation in Step3/figure5 correct?
